Skip to main content
Help Center

Maintain contract data & working hours

The contract data dialog in detail — weekly working hours, working days, leave entitlement, public holiday calendar, schedulable allocation, half working days, the three time-tracking modes and the overtime rules.

Prerequisites

An employee’s contract data governs how much they are meant to work, how much leave they receive and what their overtime account is measured against. It sits as a time slice in the employee detail manager under HR ▼Contract data and working hours. Every contract change creates a new slice — the previous one ends one day earlier, so that you can reconstruct the state for any given day.

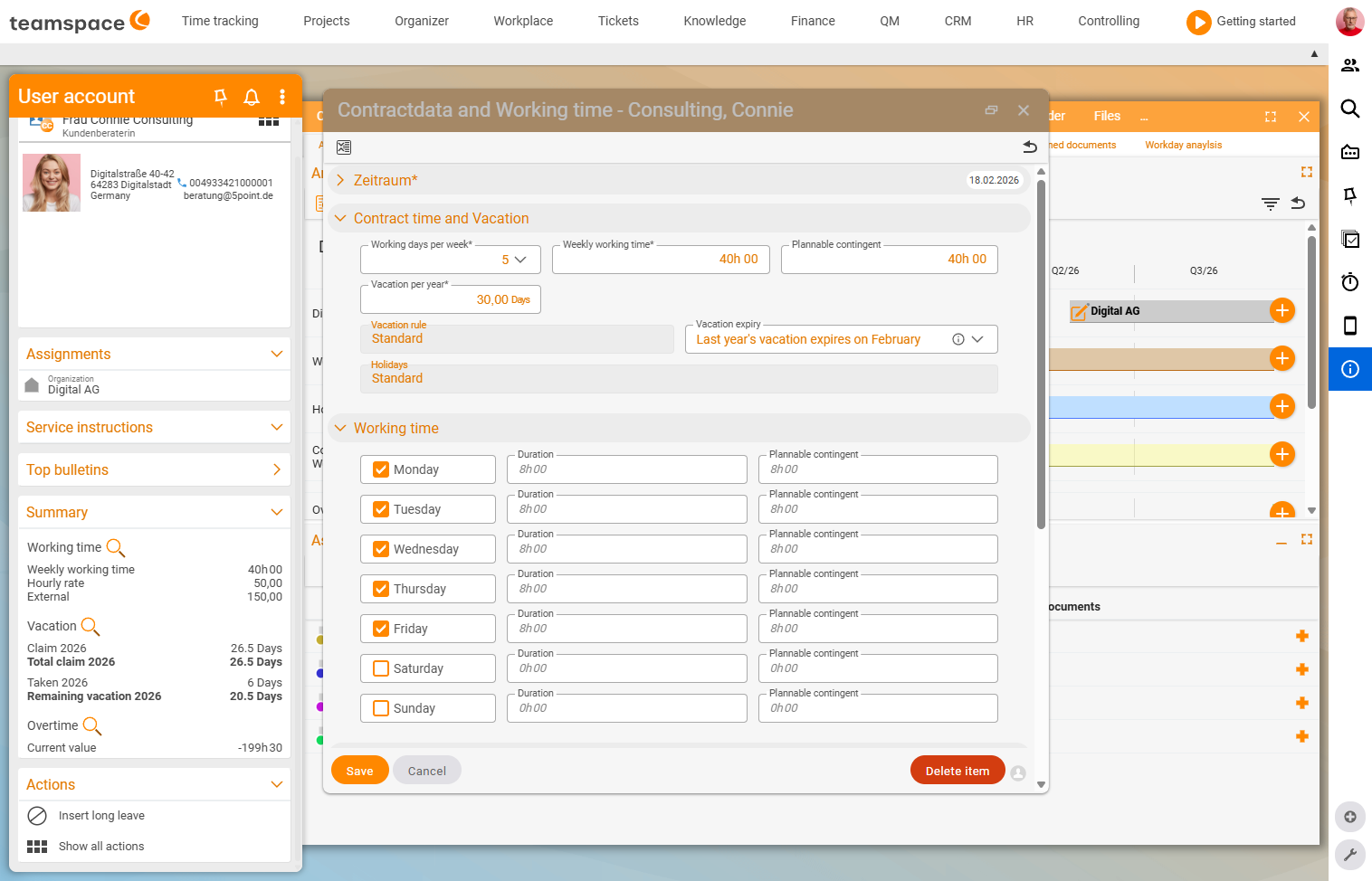

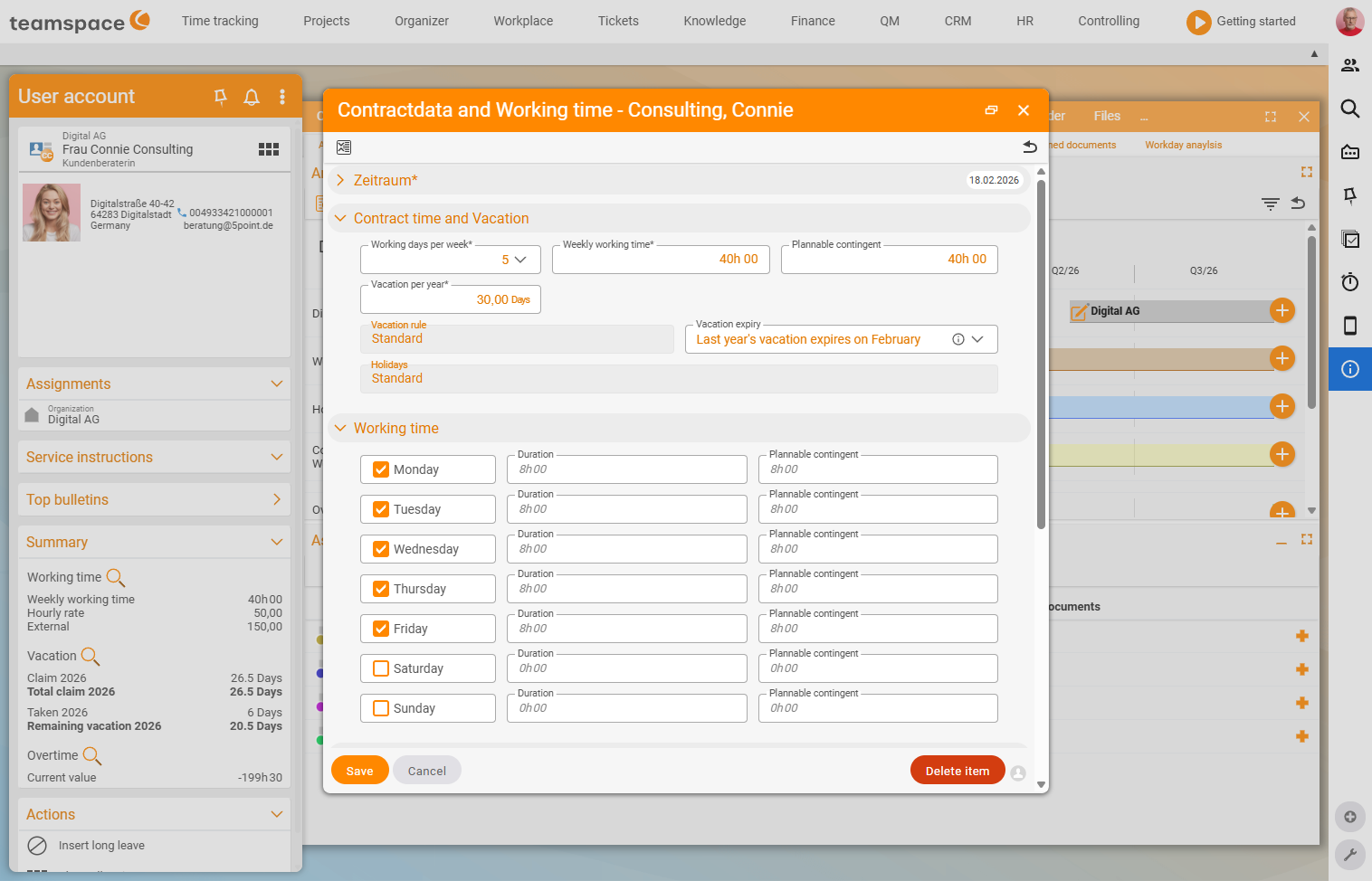

Contract data dialog with working days per week (5), weekly working hours (40h), schedulable allocation, leave days per year (30), leave rule, leave expiry, public holidays and the weekday selection Monday to Friday (active) with duration and schedulable allocation per day
The contract data dialog: working days per week, weekly working hours, leave days per year, leave rule/leave expiry and public holidays, and below them the weekday selection (Mon–Fri) with duration and schedulable allocation per day.

The working hours block

The dialog contains three blocks: the working hours, the time-tracking rules and the overtime rules. The working hours block contains:

  • Weekly working hours: The number of hours the employee is meant to work per week.
  • Working days: On which weekdays they regularly work. The system distributes the weekly working hours across these days automatically, and you can override the distribution per day manually. The total must add up to the weekly working hours again — otherwise the system reports an error.
  • Annual leave entitlement: How many leave days they have per year.
  • Public holiday calendar: Which regional public holiday list applies to this employee (more under Set up leave).
  • Schedulable allocation: How much of the contractual time is available for project planning. If an employee has a 32-hour contract and an allocation of 28, capacity planning only schedules 28 hours — the remaining 4 hours stay free for internal tasks.

Info: Weekly working hours, working days and leave entitlement are interconnected. With a four-day week, an employee normally receives fewer leave days than with five. teamspace shows a note indicating how the leave entitlement compares to a five-day week.

How weekly working time is distributed across weekdays

In the Working hours section you select the weekdays on which work is done. Each weekday has a tick, which means: does the employee have to request leave for this day? For Saturday and Sunday it is normally switched off.

The distribution has consequences for how many hours a leave, public holiday or sick day offsets. By default, a full leave day is deducted from the account even for a shorter working day. With a 38-hour week, a leave day on Friday then only offsets 6 hours — whereas on a Thursday it offsets 8 hours. If the difference is large enough, the next step is worth it: half working days.

Half working days

Half working days are a tool for mapping weekdays of differing length more cleanly.

Example: Anna works 12 hours per week — 8 hours on Mondays, 4 hours on Tuesdays. A normal leave day would count the same on Mondays and Tuesdays, even though Anna’s Tuesday is only half as long. If you switch on the Half working days function in the configuration, you can mark Anna’s Tuesday as a half working day. A leave day then always corresponds to 8 hours, and for Tuesdays the system only deducts half a leave day (4 hours).

HR module, an employee's Contract data and working hours dialog with the Working hours accordion: a table per weekday (Monday to Sunday) with ticks and hours fields, plus the accordions Contract type and leave and Time tracking / overtime
The Contract data and working hours dialog with the working hours table per weekday — here you set part-time work and, when the function is enabled, half working days.

Important: When you enable half working days, Anna effectively has a 1.5-day week. You have to adjust the leave entitlement accordingly — otherwise the maths no longer adds up.

Half public holidays and half working days

When a half public holiday falls on a half working day, or half a day’s leave on a half public holiday — this is not regulated by law. teamspace handles it as follows: no work is to be performed when

  • half a day’s leave is taken on a half working day,
  • a half public holiday falls on a half working day,
  • a half public holiday falls on a full working day and half a leave day is taken.

Time-tracking basis — three modes

In the Time tracking and overtime block you define what working time and the overtime account are measured against. Three modes are available:

  • Attendance time: The employee checks in and out. The difference from the contractual time is added to the overtime account.
  • Project time: The employee books their time against specific projects. The total of the project times counts as working time, and the comparison with the contractual time fills the overtime account.
  • Trust-based working time: The employee can record times, but no overtime account is kept.

Which basis you choose depends on the working model: employees with project responsibility usually book project time, administration often runs via attendance, and management or independent staff usually work with trust-based working time.

Breaks, office hours, daily limit

Three further rules in the same block help when your time tracking needs more discipline:

  • Break rules: Minimum breaks for attendance times — for example a 30-minute break from 6 hours of attendance. Not enabled by default.
  • Office hours: so that travel times within office hours can be valued differently from those outside them.
  • Daily limit: prevents the recording of project and attendance times above this limit. In some companies, employees may only work 10 hours per day even under flexitime.

Overtime rules

In the same dialog you govern how the overtime account grows and when it is capped:

  • Overtime threshold: The value above which a month’s or year’s additional hours are transferred to the overtime account. If the threshold is set at 2 hours, only the hours from the third additional hour onwards move to the account.
  • Max. overtime / month: The maximum number of overtime hours per month. Anything above this expires.
  • Max. overtime in total: The highest level the overtime account is allowed to reach. Once it is reached, further hours are no longer recorded.

If you wish, the expiring overtime can be sent automatically for payout via Pay out further overtime with the monthly invoice. How overtime is calculated, adjusted and paid out in detail is described on the Overtime account page.

Time-account traffic-light system

So that you keep an overview with many employees on different contracts, there is a traffic-light system for the current state of the working-time account. At a glance you can see whether the level is “in the green”, slipping into yellow or in the red. You set the thresholds in the time-tracking configuration.

Common questions & needs

You want to …How to
Switch an employee to part-timeReduce the weekly working hours and working days, and adjust the leave entitlement – step by step under Adjust contract data & salary.
Map fewer working hours on FridaysOverride the hours distribution per day in the working hours block; for a large difference, use Half working days.
Prevent someone from booking over 10 hrs/daySet the Daily limit in the time-tracking block.
Specify that no overtime account is keptSet the time-tracking basis to Trust-based working time.
Leave a buffer for internal tasks in planningSet the Schedulable allocation lower than the weekly working hours.
Enforce minimum breaksEnable Break rules (e.g. 30 min from 6 hrs).
