Skip to main content
Help Center

Set up the warning system

Configure warning mechanisms for capacities: thresholds for deviations between time budget, resource schedule and booked times, check status and check report.

Prerequisites

  • Administration access to the project settings

The warning system turns deviations between plan and actuals into a readable check status per capacity. You activate it centrally in the configuration and then read the results in every capacity and in the capacities list.

1. Activate warning mechanisms

You find the path under Configuration → Projects → Settings in the Capacities – warning system accordion (verified live on 22 June 2026). There you activate various warning mechanisms via switches – each one can be turned on individually. Available live, among others:

  • Team values vs budget – the team time budget against the master-data budget.
  • Resource schedule vs budget – the resource schedule against the time budget.
  • Forecast and Project times – booked/forecast times against the plan.
  • Open project budget – the remaining budget.

Each warning mechanism can be activated individually – you switch on only the ones that suit the way you work.

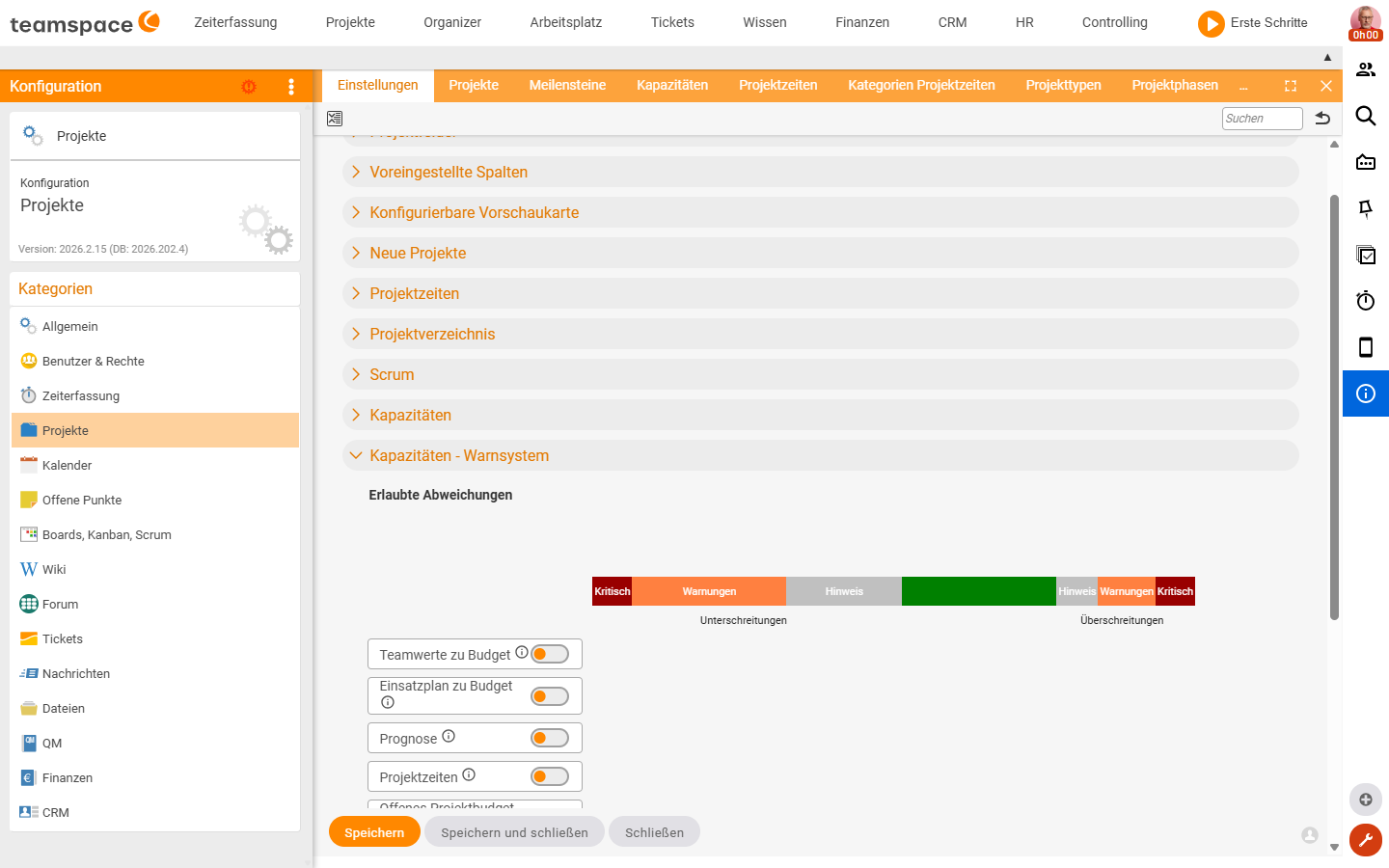

Configuration Projects Settings, Capacities - warning system accordion: Permitted deviations with the level bar Critical/Warning/Notice (shortfalls) and Notice/Warning/Critical (overruns), below them the switches Team values vs budget, Resource schedule vs budget, Forecast, Project times
The warning system in the project settings (`Configuration → Projects → Settings → Capacities – warning system`): "Permitted deviations" with the levels Notice/Warning/Critical and the individually switchable warning mechanisms.

2. Set thresholds

For each warning mechanism you set several thresholds that, on a deviation – positive or negative – trigger one of three levels:

  • Notice – a small deviation, no action needed, but visible.
  • Warning – a noticeable deviation, someone should take a look.
  • Critical – a serious deviation, action urgently required.

You define the thresholds either as fixed hour values (e.g. >10 hours deviation) or as percentages (e.g. >15% deviation).

3. Adjust per capacity

You then see all activated mechanisms in the master data of every capacity in the Capacities – warning system accordion. There you can adjust or deactivate them per capacity – for instance when a project is deliberately meant to run overbooked.

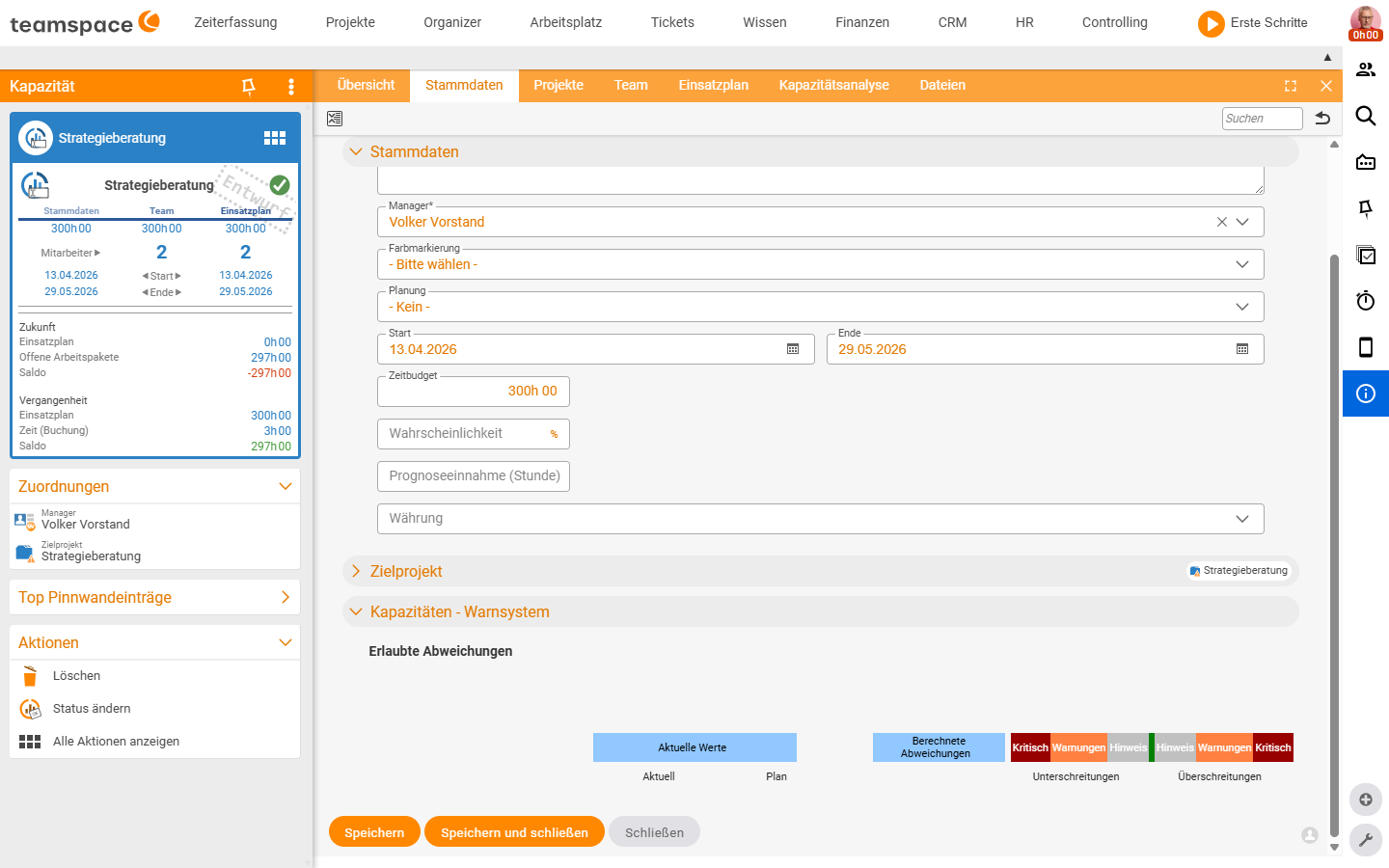

Capacities - warning system accordion in the master data of a capacity: Permitted deviations with Current values (Current, Plan) and Calculated deviations, level bar Notice/Warning/Critical for shortfalls and overruns
The "Capacities – warning system" accordion in the master data of a capacity: here you adjust the "Permitted deviations" per capacity or deactivate mechanisms.

When a deviation occurs, it appears in two places: in the capacity’s Capacities – warning system accordion and directly in the resource schedule, where the deviation sits.

4. Read the check status and check report

The result of all warning mechanisms combined flows into the Check status – visible in the Check status list column with the values OK, Warning, Error, Critical. On the left of the list view you filter by it and so quickly find the capacities that need attention.

Further details on the individual triggers are in the Check report column, where notice texts and warning reasons appear – for instance “Employee X is overbooked by 8 hours in week Y”.

Common questions & needs

You want to …How to
Be warned when more is scheduled than budgetedActivate the “Resource schedule deviates from time budget” warning mechanism.
Recognise when bookings deviate from the planActivate the “booked times deviate from the resource schedule” warning mechanism.
Only be alerted on larger deviationsSet the threshold higher (fixed hours or percentage) and assign the Warning/Critical level.
Let a capacity deliberately run overbookedIn the capacity’s Capacities – warning system accordion, deactivate the mechanism.
Quickly find all problematic capacitiesIn the list, filter by Check status (Warning/Critical) via the filter box.
See the exact reason for a warningOpen the capacity’s Check report column.

Notes

  • The warning system reckons plan against actuals – meaningful warnings require booked times (see Topic: Time tracking).
  • The triggered issues also appear, aggregated, in the Capacity planning report in the Issues column – see Analyse capacities.
